Fish Creek Bridge (Bobs Lake Road)
Update November 21, 2025

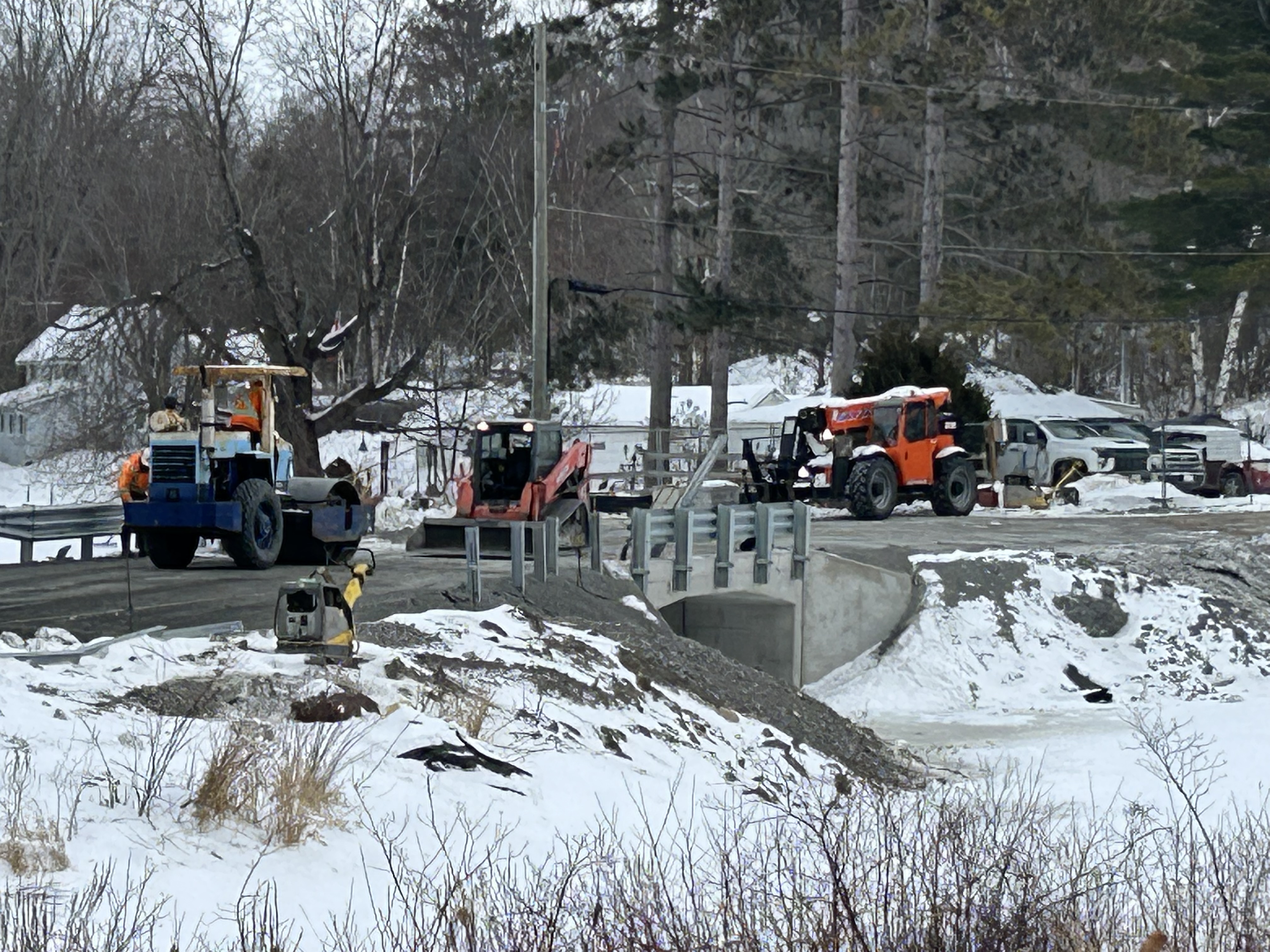

Work at the Fish Creek Bridge has progressed further this week with the completion of the rebar and forming for the two main footings that will support the new pre-cast bridge structure. Thomas Fuller Construction’s advanced the pours of the concrete to complete both footings today and favourable weather lies ahead for the curing process. Works will continue next week on preparation grading activities relating to the installation of the wing walls while concrete continues to cure.
Road closure updates have been issued through the Municipal 511 system to all emergency service providers along with school transportation providers. The bridge construction project will continue through to end of December when the bridge is forecast to be re-open for use on a gravel surface.
Update: November 17, 2025
Despite some significant setbacks on the construction of the site protection and de-watering system, the Fish Creek Bridge structure is taking shape. The levelling slabs were poured on Monday, November 10 and will form the base of the new bridge foundation.
Bridge crews were on-site last week placing the reinforcing steel for the new keyed footings on the north and south sides of the creek. Pouring of the concrete on the new footings is scheduled for this week. The main structure that makes up the new bridge is made up of pre-cast components that will ultimately be delivered to site. This will mean that the latter phases of construction work will be less impacted by the poor weather.
Update: September 23, 2025:
Due to unforeseen site conditions, completion of the Fish Creek Bridge Project will be delayed.
Crews have been progressing well with work on excavation and shoring. However, during construction, it was discovered that bedrock was deeper than what the original geotechnical investigations projected. This change means that the cofferdam installation is more complex, with increased structural design efforts to weld and brace supports for the outer walls. Accordingly, the construction plan must be adjusted to reflect these changes.
Revised schedules project that construction will be completed by November 21. For questions, please reach out to our Public Services department at 613-376-3027 or email .
Update: July 8, 2025:
Please be advised that Bob's Lake Road will be closed to all traffic between Walleye Lane and Morton Point Lane starting today (Tuesday, July 8, 2025), through to Tuesday, September 30, 2025. The closure date was changed by the third party construction company. We apologize for any inconvenience.
Update: June 24, 2025:
Please be advised that Bob's Lake Road will be closed to all traffic between Walleye Lane and Morton Point Lane starting Wednesday, July 2, 2025, through Tuesday, September 30, 2025. This closure is necessary to facilitate the removal of the existing bridge and construction of a new two-lane bridge across Fish Creek. Detour routes will be clearly marked and will route traffic to the other side of the closure via Road 38 through Parham. Access to all residences and businesses for the public and emergency services will be maintained at all times. This project is part of ongoing infrastructure improvements to enhance safety and transportation in the area. For further information, please contact the Public Services Department at 613-376-3027.
Update, May 12, 2025:
The Fish Creek Bridge Replacement contract has been awarded to Thomas Fuller Construction Co. Ltd. Thomas Fuller’s crews will be installing the necessary environmental fencing controls at the project site in early May. The exact schedule for the bridge demolition and road closure is not currently set however works will be scheduled when in-water restrictions are lifted on July 15th, 2025. Further updates will be provided on the project web page in late June.
Further project details can be found in the Public Meeting Presentation in the documents section.
March 12, 2025: New Load Restriction in Effect – Fish Creek Bridge
Please be advised that recent engineering inspections carried out in 2025 on the Fish Creek bridge (Bob’s Lake Road) have identified new structural deficiencies that warrant cautionary changes to the posted load restrictions currently seen at the crossing.
As a result, effective Monday, March 24, 2025, the Township of South Frontenac will be implementing new load restrictions on the bridge that will limit the maximum weight to 5 tonnes per axle for all vehicles until the bridge replacement is completed in the summer of 2025. The new load restriction is being implemented in accordance with By-Law 2025-12 and will be subject to enforcement under the Highway Traffic Act, R.S.O., 1990.
For further information on these load restrictions, please contact the Public Services Department at 613-376-3027.
Past News:
Public Meeting: The Council of the Township of South Frontenac held a Public Meeting on the Proposed Replacement of the Fish Creek Bridge located on Bob's Lake Road on February 11, 2025, at 7:00 pm. The presentation from this public meeting can be viewed under the 'Documents' to the right.

Information on Project: The Fish Creek bridge is a single lane bridge currently located on Bob’s Lake Road just south of the intersection of Fish Creek Road. This concrete structure has a deck width of 5.2m and currently spans a distance of 6.7m over a navigable waterway connecting to Bobs Lake. The crossing also has posted load restrictions which limit the weight of vehicles that are able to use the crossing. Available records suggest that this bridge was constructed around 1927 and is nearing the end of its useful service life.
The Township has initiated studies to evaluate the condition of the bridge and is evaluating possible strategies for replacement.
Key considerations for the project include the following:
- Improve level of service to support a new two-way vehicle crossing
- Upgrade guide rail systems to meet current roadside safety standards
- Structural designs that will support removal of posted load restrictions
- Preservation of the navigable opening on Fish Creek to allow continued movement of small boats and watercraft
This project is being planned as a Schedule B project under the 2023 Municipal Class Environmental Assessment process as prescribed under the Ontario Environmental Assessment Act. All replacement options will consider social, environmental and economic impacts.
A Public Information Meeting will be held in the future to provide more information and solicit feedback on the project. Details and dates will be advertised once available.

Fish Creek Bridge (Bobs Lake Road)

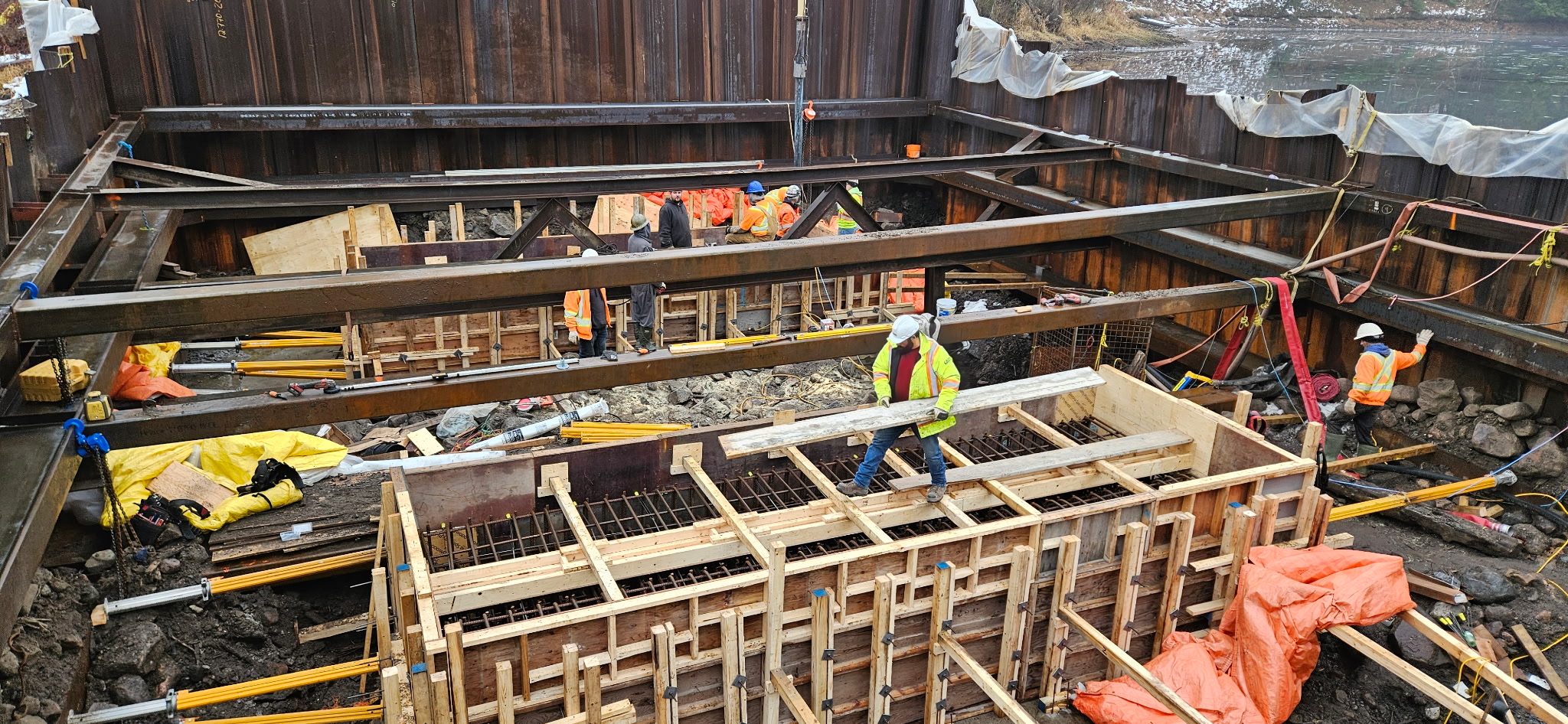

Update November 21, 2025
Work at the Fish Creek Bridge has progressed further this week with the completion of the rebar and forming for the two main footings that will support the new pre-cast bridge structure. Thomas Fuller Construction’s advanced the pours of the concrete to complete both footings today and favourable weather lies ahead for the curing process. Works will continue next week on preparation grading activities relating to the installation of the wing walls while concrete continues to cure.
Road closure updates have been issued through the Municipal 511 system to all emergency service providers along with school transportation providers. The bridge construction project will continue through to end of December when the bridge is forecast to be re-open for use on a gravel surface.

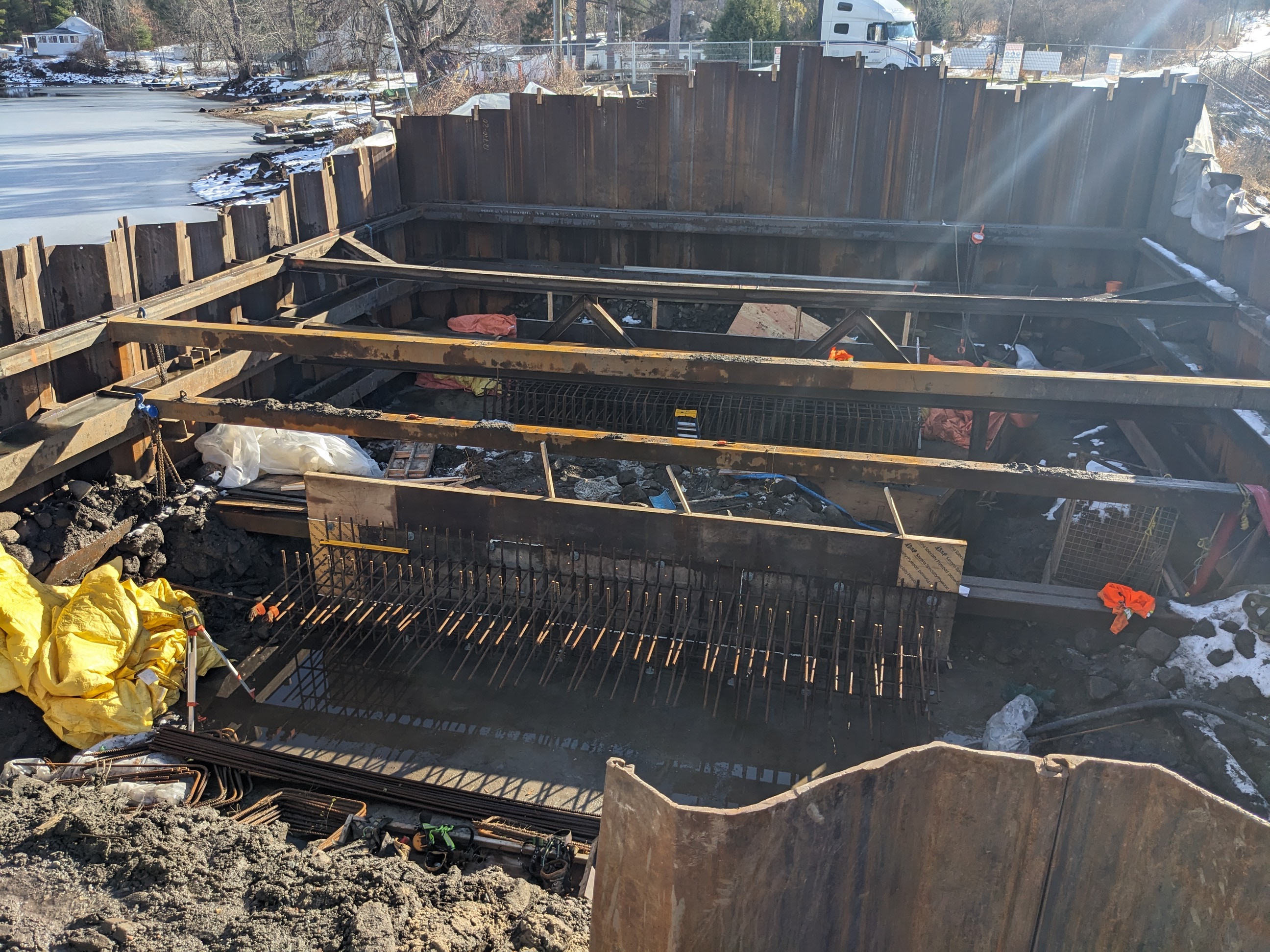

Update: November 17, 2025
